Monaghan County Council is delighted that construction commenced in July 2020 on this new and exciting project ‘Monaghan Peace Campus’. This €17.6 million project will provide a new four storey mixed use community building, comprising of a Cultural Heritage Centre, Library, Youth Facility, Shared Community Multi-Functional Space with External Community Space and Underground Parking.
This project is supported by the EU’s PEACE IV Programme, managed by the Special EU Programmes Body (SEUPB) https://www.seupb.eu/
The financial support provided through the PEACE IV Programme is €9,541,081.
Monaghan County Council submitted an application in October 2021 seeking additional funding and SEUPB granted an additional €3.76million, therefore the revised total grant funding from SEUPB is €13,302,454.17.
Click here to read more: ‘Monaghan County Council Signs Contract For The Peace Campus Project‘
‘SEUPB Project Case Study – Progress to Date’ – Please find a link HERE
Drone Footage of the Peace Campus Progress - March 2024
Progress to Date - Monaghan Peace Campus Time Lapse Footage September 2020 to February 2024
Summary of Progress to Date: Q4 2023 (Oct – Dec 2023)
- Painting, decorating and tiling nearing completion;
- Electrical containment (2nd fix) substantially complete;
- Mechanical Installation (2nd fix) substantially complete;
- Joinery (2nd Fix) substantially complete;
- Soft Landscaping substantially complete;
- Eir & ENET (Utilities) substantially complete;
- External Railings – Installation substantially complete;
- Paving of external areas almost complete.
Summary of Works Completed:
- Level 4 flat roof coverings, insulation and plant guarding complete;
- Electrical containment (1st fix) on all Levels complete;
- Mechanical installation (1st fix) on all Levels complete;
- ESB connection to substation complete;
- Installation of built in furniture complete;
- Lift installation completed – final snagging and commissioning commenced;
- Gas Tank and Gas Boilers installation works complete.
Summary of Progress to Date: Q3 2023 (July – Sept 2023)
Works Ongoing:
- Level 4 flat roof coverings and insulation nearing completion;
- Painting, decorating and tiling ongoing;
- Electrical containment (1st fix) on all Levels substantially complete;
- Electrical containment (2nd fix) ongoing;
- Mechanical installation (1st fix) nearing completion on all Levels (0 – 4);
- Mechanical Installation (2nd fix) ongoing;
- Joinery (2nd Fix) ongoing;
- ESB works for power supply ongoing;
- Soft Landscaping works ongoing;
- Gas Tank installation works ongoing;
- Eir & ENET (Utilities) works ongoing.
Works Completed:
- Installation of zinc cladding to Level 4 roof completed;
- Joinery (1st fix) & Timber screens completed;
- Bench Seating brackets to Planters completed;
- Level 4 Multi Use Room – Roof works completed
- External & Internal brickwork complete.
Summary of Progress to Date: Q2 2023 (Apr – June 2023)
Works Ongoing:
- Roof works to Level 4 Multi Use Room nearing completion;
- External & Internal Brickwork substantially complete;
- Curtain walling framing and glass installation;
- Painting and decorating;
- Electrical Containment (1st fix) on Levels 1, 2, 3 & 4;
- Mechanical Installation (1st fix) on Levels 1, 2, 3 & 4;
- Joinery (1st fix) and timber screens;
- ESB works for power supply.
Works Completed:
- Stone Cladding on building;
- Level 3 Community Room Roof Works;
- Installation of floor insulation and screed on Levels 2, 3 & 4;
- Level 4 Glass Balustrade bracket works
- Roof finish to External Stage
Summary of Progress to Date: Q1 2023 (Jan – March 2023)
Works Ongoing:
- Roof works to Level 3 Community Room and Level 4 Multi Use Room
- External & Internal Brickwork
- Curtain walling framing and glass installation
- Electrical Containment (1st fix) on Levels 1, 2 & 3
- Mechanical Installation (1st fix) on Levels 1, 2 & 3
- Installation of Stone Cladding to External & Internal areas
- Installation of Zinc Cladding to Level 4 roof
- RC Snagging to external elements
Works Completed to date:
- Insulation and wall tie channel restraint system installation to external facades
- External SFS Stud & Framework installation to all levels
- Level 4 Glass Balustrade bracket works
- Roof finish to External Stage
- Installation of Level 2 floor insulation and screed
- Podium Deck area outside Staircore 1 and North Road concrete installed
- External Stair 2 from Level 0 to Podium Deck
Summary of Progress to Date: Q4 2022 (Oct – Dec 2022)
Works Ongoing:
- Electrical Containments on Levels 0 – 1
- Installation of Windows (Glass)
- External & Internal Brickwork
- Roof Works to Level 4 Multi Use Room
- Roof Works to Level 3 Community Room
- External SFS Stud and Framework installation to Levels 1 – 4.
- External Stair 2 from Level 0 Podium deck
Works Completed to date:
- External Stair flight 3 and landing including walls complete;
- Podium Deck area at Staircore 1 and North Road prepared and concrete installation complete;
- 24 no. Window Frames installed around all facades of building;
- Formation of concrete external Stair beside ESB Substation complete;
- Lower Planter Walls complete;
- Walls to External Stage area complete.
Progress to Date: Q3 2022 (July – Sept 2022)
Works Ongoing:
- Internal Installation of SFS commenced on Level 1
- Installation of IG Masonry supports ongoing at Level 2
- Works to Planter Walls ongoing.
- Works on External Stage Area have commenced.
- Brickwork ongoing at Levels 1 – 4 on all elevations
Works Completed to date:
- Insitu concrete stairs formed up to Level 4 slab in Staircore 1.
- Internal Stair 2 flights and landings from Levels 1 – 3 complete.
- Works on Level 4 parapet walls and Lift shaft complete.
- Brickwork at Level 0 complete.
- ESB Substation: Brickwork and PVC Roofing complete.
Progress to date: Q2 2022 (April – June 2022)
Works Ongoing:
- Electrical Containment installation at Level 0 almost complete;
- Level 4 formwork ongoing;
- Brickwork commenced at Level 0 – Internal & External;
- Installation of SFS walling;
- Installation of IG Masonry supports.
Works Completed to date:
-
- Level 3 – 4 Columns;
- Staircore 1 Level 3 walls;
- Level 4 slab poured;
- Construction of ESB Substation brickwork;
- Concrete Stairs formed up to Level 3 in Staircore 3;
- Concrete Stairs formed up to Level 2 in Staircore 1.

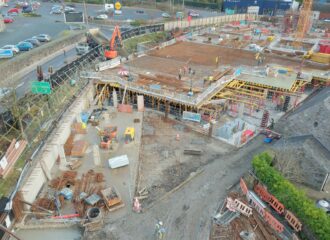

Q1 2022 (January to March 2022)
Works ongoing:
- Casting of North Road retaining wall
- Construction of Stairs 1 & 3 at Level 2
- Formwork on Level 3 commenced
- Formwork to Atrium Wall ongoing
Works completed to Date:
- Casting of Level 0 slab
- Casting of Level 1 and Podium Slab
- Casting of Level 1 – Level 2 columns
- Casting of Level 2 slab
- Casting of Level 2 – Level 3 Columns
Progress to Date
Q4 2021 (October to December 2021)
Works ongoing:
- Casting Level 0 – Level 1 Columns
- Installation of temporary Soffit formwork to Level 1 area
- Tying of reinforcement and casting concrete slab to Level 1 area
- Tying reinforcement on Level 1 – Level 2 Structural Columns
- Casting reinforced concrete walls to Level 1 Stair 3 core
- Erection of temporary framing to section 2 North Road retaining wall
- Casting of substation trench walls and pits.
Works completed to Date:
- Substructure piles, pile caps and associated foundation
- Storm drainage and foul pipework beneath Level 0
- Majority of Level 0 reinforced concrete slab now cast
- Reinforcement and concrete works to Level 0 – Level 1 structural columns
- Level 0 lift shaft and structural walls
- Section 1 of North Road retaining wall
- Perimeter drainage works and filter drains
Progress to Date
Q3 2021 (July to Sept 2021)
Works ongoing:
- Casting of Level 0 carpark concrete slab ongoing
- Tying reinforcement steel to Level 0 – Level 1 structural columns ongoing
- Tying reinforcement steel to Level 0 carpark slab substantially complete
Works completed to Date:
- Project Signage Boards at 3 nr. Locations erected
- Piling works and associated pile cap foundations
- Construction of Podium ramp structure
- Sub-floor drainage, interceptors and ducting works
- Construction of retaining walls ongoing including temporary works framing
- Sub-floor drainage, interceptors and ducting works
- Attenuation tanks and culvert replacement works
Progress to Date
Q1/Q2 January-June 2021
Monaghan Peace Campus Construction site was closed from 8th January 2021 due to Covid19 Public Health Measures & Restrictions. Site re-opened 4th May 2021.
Works completed to date include:
- Temporary Safety Barriers installed along North Road
- Culvert and associated chamber installed
- Level 1 podium ramp structure complete
- Attenuation tanks cast and precast cover slabs placed
- Electrical switch room cable trench cast
- Foundations cast and sub-structure masonry walls built to base of new stone walls at Glaslough St.
Works currently ongoing include:
- Sub-structure works to include pile caps and associated structure foundations
- Preparation of sub-station floor in progress to receive cable trenches
- Lift shaft on Level 0 cast and waiting Level 1 deck slab
- Casting of Pile caps 98% completed
- Temporary shorting erected to Stage 1 of North Road Retaining Wall
- Tanking membrane applied to approx. 50% of North Road retaining wall
- Installation of Storm drainage network ongoing at Level 0
Monaghan Peace Campus Q1/Q2 January-June 2021 – Click on the images below for a larger image.
Progress to Date
Q4 September-December 2020
Works completed to date include:
- Establishment of site compound, office and welfare accommodations.
- Installation of foundation bearing piles and associated mini pilling.
- Erection of Tower Crane and associated foundations.
Works currently ongoing include:
- Casting of foundation pile caps, ground beams and associated stair core foundation slabs.
- Fixing of reinforcement to pile caps, level 0 structural columns, level 0 podium ramp walls and level 0 stair core walls.
- Construction of ESB sub-station.
- Construction of level 0 lift core structure.
- Construction of 2 nr. Attenuation tank bases.
- Storm drainage pipework and service ducting.
Monaghan Peace Campus Q4 – Click on the images below for a larger image.
Q3 July – September 2020 The site is secure and hoarding is erected. Existing perimeter structures have been demolished. Clearing of site is completed. A Time Lapse camera has been installed. Test Piles installed and tested. Piling is complete. Contractor has liaised with neighbouring residents and Government Departments.
Monaghan Peace Campus Q3 – Click on the images below for a larger image.
Monaghan Peace Campus Architects Presentation
Click on the images below for a larger image.
